Legacy vs. Enhanced Holiday Schedule Model

The Enhanced Holiday Schedule model represents a significant improvement over the legacy approach. The information below provides a detailed comparison to help you understand the differences and plan your transition.

At a Glance

Legacy ModelEnhanced Model
Assignment MethodDirect field on Resource recordSeparate Holiday Schedule Assignment object
Schedules per ResourceOne schedule onlyMultiple schedules supported
Date Range ControlNone – all holidays appliedPrecise start/end date control
Schedule ChangesRequires updating Resource recordCreate new Assignment, adjust date ranges
Regional FlexibilityLimited – one schedule covers allFull support for regional + global combinations
Bulk ProcessingSynchronous onlyAsync processing with status tracking

Detailed Comparison

Assignment Flexibility

Legacy Model:

  • A resource could only have one holiday schedule assigned via a lookup field on the Resource record
  • Changing schedules required editing the Resource record directly
  • No way to have different schedules apply at different times

Enhanced Model:

  • Resources have a related list of Holiday Schedule Assignments
  • Each assignment specifies which schedule applies and for what date range
  • Multiple assignments can be active simultaneously (e.g., Global + Regional)
  • Schedule transitions are handled by adjusting assignment date ranges

Date Range Control

Legacy Model:

  • All holidays in the assigned schedule applied to the resource
  • No way to limit which holidays affected a resource
  • Past and future holidays all created forecasts

Enhanced Model:

  • Each assignment has explicit Start Date and End Date fields
  • Only holidays within the date range create forecast records
  • Easy to set up year-bounded assignments (e.g., 2025 only)
  • Changing date ranges automatically adds or removes forecasts as needed

Regional and Multi-Schedule Support

Legacy Model:

  • Organizations needed to create consolidated schedules for each unique combination
  • A resource in the US office working on a global team might miss company-wide holidays or have incorrect regional holidays
  • Complex to manage when resources move between regions

Enhanced Model:

  • Create focused, single-purpose schedules (US Holidays, UK Holidays, Global Company Holidays)
  • Assign multiple schedules to each resource as needed
  • Handle transfers by adjusting assignment date ranges
  • Clean separation between regional and company-wide holidays

Processing and Performance

Legacy Model:

  • All processing was synchronous
  • Large-scale schedule changes could timeout or hit limits
  • No visibility into processing status

Enhanced Model:

  • Intelligent async processing for bulk operations
  • Automatic chunking based on workload size
  • Status field shows when processing is complete
  • Self-healing batch operations for very large volumes

Migration Considerations

Organizations transitioning from the legacy model should:

  • Identify current schedule assignments on Resource records
  • Create corresponding Holiday Schedule Assignments with appropriate date ranges
  • Test with a small group of resources before bulk migration
  • Clear legacy field values after confirming new assignments work correctly

Migration Steps

Step 1: View and Export impacted Resources

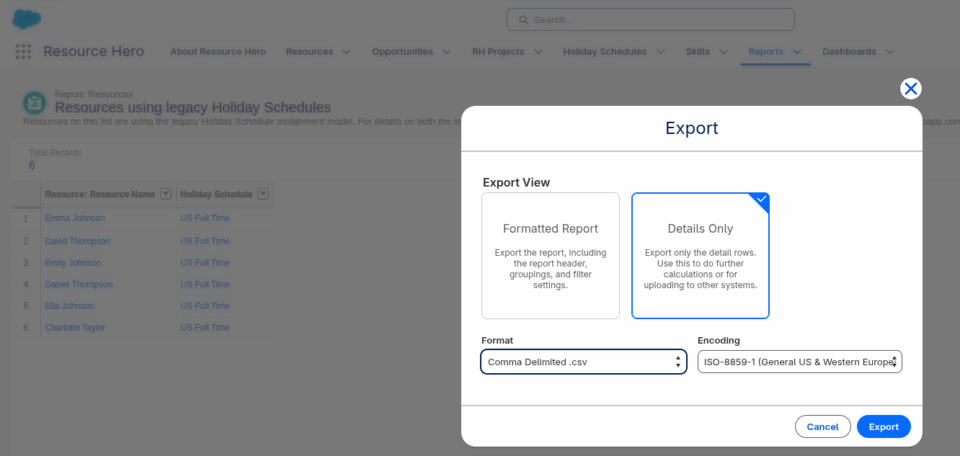

From within the Resource Hero Admin Reports report folder, run and export the Resources using legacy Holiday Schedules report as a CSV file. Resources on this report are still assigned a Holiday Schedule at the Resource level.

Step 2: Plan Date Ranges

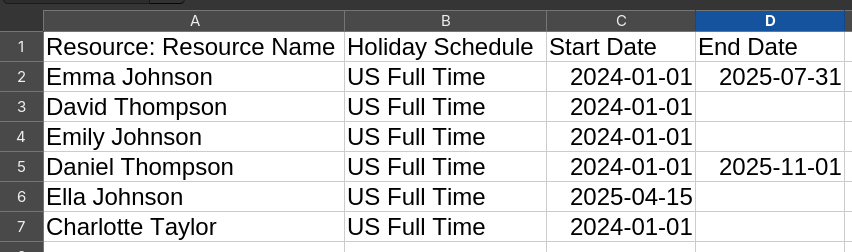

Edit the CSV file and add columns for Start Date and End Date, then add dates for each Resource

Step 3: Create New Holiday Schedule Assignments

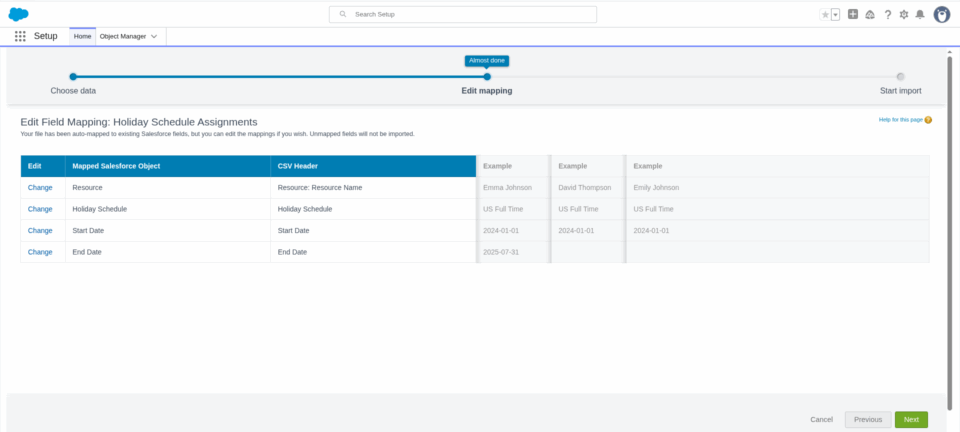

Use the updated CSV file to bulk create Holiday Schedule Assignment records:

Step 4: Verify

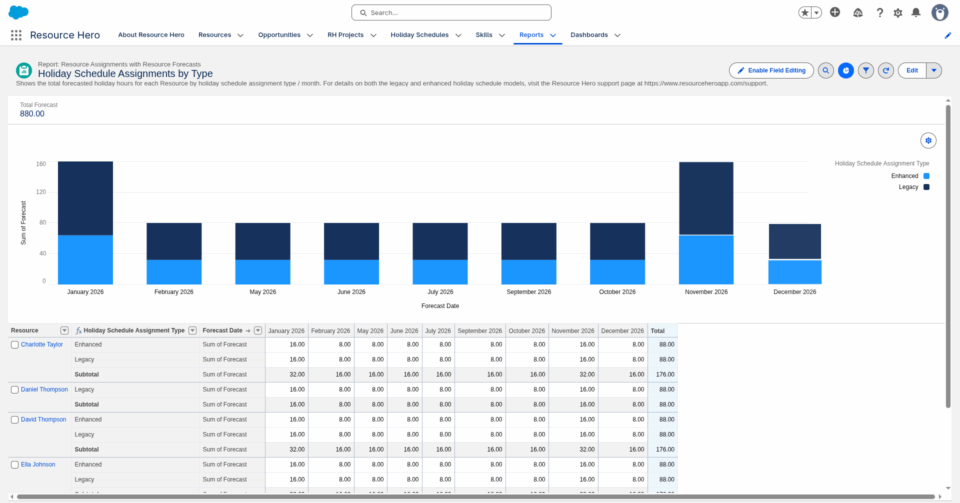

From within the Resource Hero Admin Reports report folder, run the Holiday Schedule Assignments by Type report and confirm that the load was successful. At this step, hours may be shown in both the Enhanced type (hours that you just loaded) and the Legacy type (hours that we will remove in the next step).

Step 5: Clean Up

Now that the new Holiday Schedule Assignments are in place, you can remove the legacy assignment. This can be done by clearing the Holiday Schedule field on Resource’s detail page, then click Save.

Step 6: Verify

After clearing the Holiday Schedule field from Resources, re-run the Holiday Schedule Assignments by Type report and confirm that the legacy records are removed.

Important: Avoid Using Both Models Simultaneously

The legacy Holiday Schedule field on Resource records and the new Holiday Schedule Assignment model operate independently. If a resource has both a legacy schedule assignment AND one or more Holiday Schedule Assignments, duplicate forecast records may be created for the same holidays.

Choose one model per resource. If you are migrating to the Enhanced model, clear the legacy Holiday Schedule field on the Resource record after creating the corresponding Holiday Schedule Assignment.
